Every measurement measureQuick uses to evaluate system performance depends on the system running at steady state. Steady state means the refrigerant cycle has reached thermal equilibrium: pressures, temperatures, and airflow have settled to consistent operating values rather than climbing or dropping.
During the first minutes after startup, or after any change to the system (charge added, thermostat adjusted, filter replaced), readings are transient. Transient readings do not represent actual system performance. They represent the system ramping toward its operating point.
Saving diagnostic data during transient operation is the single most common source of false failures. A system that is perfectly charged can show a failing superheat reading at minute 3 and a passing reading at minute 15. The system did not change. It stabilized.
From measureQuick's diagnostic database of 115,706 quality-filtered cooling tests: charge failure is the most common subsystem failure at 45.4% of all DQ-clean cooling tests, rising to 56.0% on piston-metered systems where superheat is the primary charge indicator. A meaningful portion of those recorded failures occur because technicians save data before the system reaches steady state. Unstable superheat readings on piston systems are especially prone to false failure because superheat is still dropping as the evaporator fills during the transient phase.
Bottom line: Patience during stabilization is the most important thing you can do for accurate diagnostics. Wait for it.
As the Cooling Commissioning walkthrough puts it: "all you have to do is deploy your probes and wait for the system to stabilize." Use the wait productively. Complete photo documentation, enter customer information, review the system profile, or finish other checklist items that do not depend on stabilized readings.
Different measurements stabilize at different rates. Here is what to look for.
| Measurement | Stable When | Typical Time |
|---|---|---|
| Suction pressure | Holds within +/-2 psi for 2+ minutes, not climbing or dropping | 8-15 minutes after startup |
| Discharge pressure | Holds within +/-3 psi for 2+ minutes | 8-15 minutes after startup |
Pressures are the foundation of superheat and subcooling calculations. If pressures are still moving, every derived value (superheat, subcooling, CTOA) is also moving. Do not evaluate charge until pressures settle.
| Measurement | Stable When | Typical Time |
|---|---|---|
| Superheat | Settles within +/-2F for 2+ minutes | 10-20 minutes after startup |
| Subcooling | Settles within +/-1F for 2+ minutes | 10-20 minutes after startup |
| Suction line temp | Holds within +/-1F | 8-15 minutes |
| Liquid line temp | Holds within +/-1F | 8-15 minutes |
| Discharge line temp | Holds within +/-2F | 10-15 minutes |
Superheat stabilizes slower than raw temperatures because it depends on both suction line temperature and suction pressure converging. Subcooling has tighter tolerance (+/-1F) because on TXV systems, a 2-3F shift can swing a pass/fail result.
| Measurement | Stable When | Typical Time |
|---|---|---|
| Total external static pressure | Holds within +/-0.02" w.c. | 1-2 minutes (fast, assuming constant blower speed) |
| Supply air temperature | Consistent cooling output (within +/-1F) | 8-15 minutes |
| Return air temperature | Consistent (within +/-1F), no occupancy or envelope disruptions | 5-10 minutes |
Static pressure stabilizes quickly because it depends on blower speed and duct resistance, both of which reach operating values within a minute or two. Supply air temperature takes longer because it depends on evaporator performance, which depends on the refrigerant cycle reaching equilibrium.
| Measurement | Stable When | Typical Time |
|---|---|---|
| Compressor amperage | Holds within +/-0.5A | 5-10 minutes |
Compressor amperage rises during startup and settles as head pressure stabilizes. On variable-speed compressors, amperage stabilization depends on when the inverter reaches its target speed.
During the transient phase (first 5-10 minutes), expect to see:
During steady state (after 10-20 minutes):
Key distinction: Small oscillations are normal at steady state. A superheat that bounces between 12F and 14F is stable. A superheat that drops from 25F to 18F to 14F over five minutes is still transient. Stability means the readings hold within a narrow range, not that they are perfectly fixed.
measureQuick includes built-in stability indicators on the Diagnostics screen. These are your primary tool for knowing when to save.
The app monitors the variance of critical measurements over a rolling time window. When the readings hold within an acceptable band for a sustained period, the stability indicator transitions from a "not ready" state to a "ready" state.
The indicator accounts for:
The stability indicator appears on the Diagnostics screen near the subsystem results. It signals one of two states:

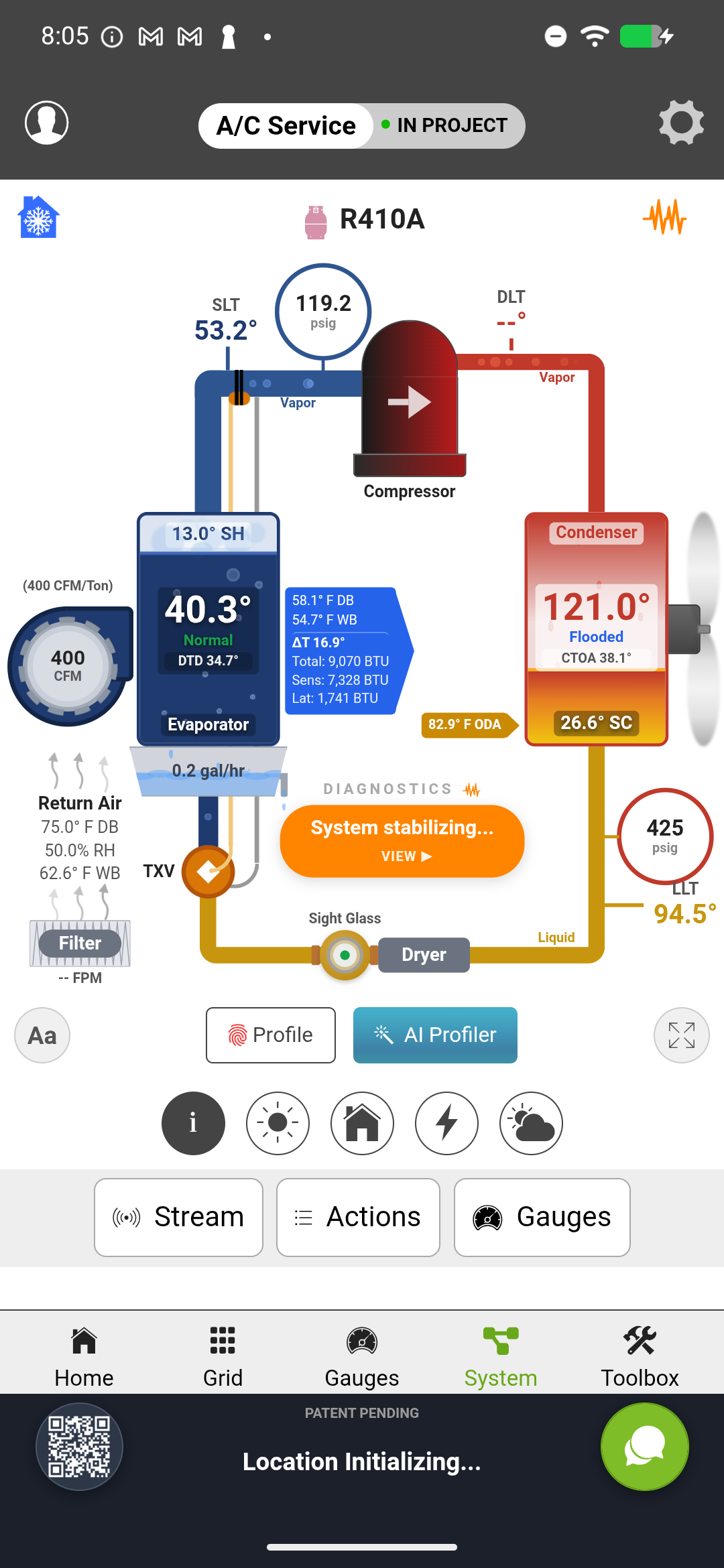

System view showing "System stabilizing..." indicator while readings settle

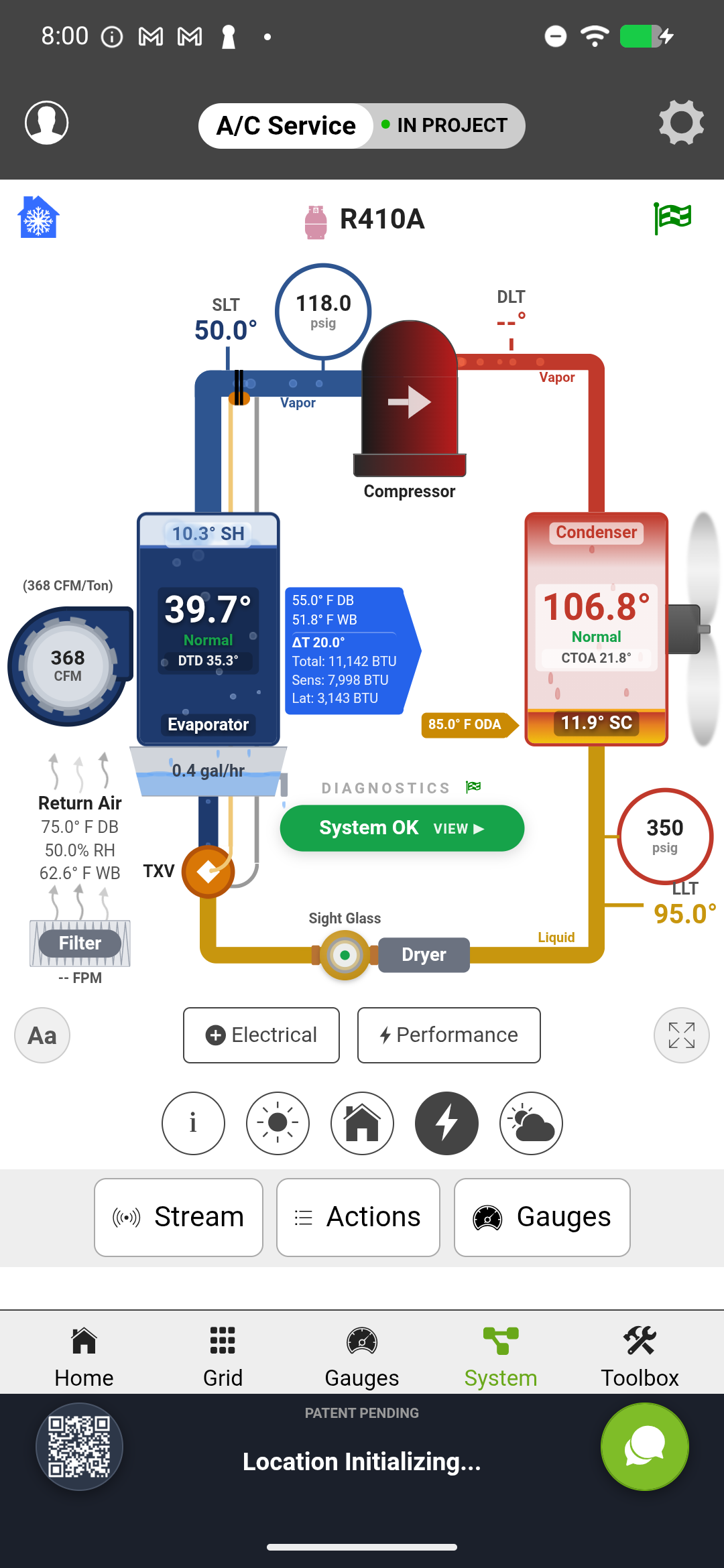

System view showing "System OK" indicator after readings have stabilized
Version 3.0 introduced improved stability detection that is more reliable than earlier versions. The updated algorithm better handles gradual drift, short-term noise from probe connections, and the specific ramp-up behavior of variable-speed equipment. If you are running measureQuick 3.0 or later, the stability indicator is more trustworthy, but the fundamentals remain the same: do not save until the indicator confirms steady state, and verify with a manual check when in doubt.
For a walkthrough of the 3.0 stability improvements, see the "What's new with measureQuick 3.0!" video referenced below.
In measureQuick 3.6 with the mQ+ interface, a progress percentage indicator shows how far along the workflow is, including stabilization progress. This gives you a visual reference for how close the system is to producing a valid diagnostic. The percentage advances as readings stabilize and workflow steps complete. Do not treat the percentage reaching 100% as a substitute for verifying stability manually, but it provides a useful at-a-glance status.
Plan for 20-30 minutes minimum for system stabilization on cooling and heating tests. The algorithm can produce a score after about 10 minutes or when the stabilization threshold is met, but rushing yields lower and less accurate vital scores. Joe Medosch and other instructors emphasized this across multiple training events (Events 3, 10, 13): technicians who try to save and leave quickly consistently get lower scores than those who wait.
For variable-speed equipment, ensure the system is running in high stage before evaluating. Low stage readings create misleading diagnostics. Methods for forcing high stage include thermostat test/charge mode, disconnect cycling, or manual thermostat override. Some thermostats hold high stage for 20 minutes, others for an hour. Understand your thermostat's behavior before relying on it.
Do not save Test In or Test Out until the stability indicator confirms steady state. This is the single most important workflow discipline in measureQuick. Everything downstream (pass/fail results, Vitals Score, customer reports, historical comparisons) depends on the data being captured at steady state.
The Vitals Score requires 9+ physical probe channels for cooling and heating tests (7+ for gas furnace). If the score is not appearing, check your probe count, but even with a valid probe count, the score is meaningless if the readings were captured during transient operation.
Some conditions push stabilization time well beyond the typical 10-15 minute window. Know what to expect.
On very hot days (105F+) or very cold days (below 30F in heating mode), systems operate near the edge of their capacity. Stabilization may take longer because the system is working harder to reach equilibrium. Additionally, outdoor ambient temperature itself may fluctuate (cloud cover, wind gusts), which affects condensing pressure and CTOA.
A system that short-cycles (runs for a few minutes, shuts off, restarts) will never reach steady state. If the system cannot sustain continuous operation for at least 10-15 minutes, that is itself a diagnostic finding. Document it. The short-cycling may be caused by a refrigerant issue, electrical fault, thermostat problem, or oversized equipment.
In this case, saving the test with unstable data is acceptable, but note the condition. The instability is the data point.
TXV (thermostatic expansion valve) systems regulate refrigerant flow actively, which can cause small oscillations in superheat as the valve hunts for its set point. These oscillations are normal but add noise to the readings. Wait until the TXV settles into a consistent hunting pattern rather than making large corrections.
Piston systems are simpler and generally stabilize faster, but superheat on a piston system is more sensitive to charge level and operating conditions. Because superheat is the primary charge indicator on piston systems, premature evaluation is especially costly. A superheat reading of 18F at minute 5 that settles to 12F at minute 15 is the difference between a charge failure diagnosis and a passing system.
Variable-speed compressors and multi-stage systems do not reach a fixed operating point the way single-stage systems do. They ramp to match load, and the ramp time varies by manufacturer and conditions. Some variable-speed systems take 20-30 minutes to reach their target operating speed.
Wait until the compressor reaches its target speed and holds there before evaluating. measureQuick's stability indicator accounts for this, but be prepared for longer waits on variable-speed equipment. The variable-speed system may modulate continuously even at steady state; the key is that the variation stays within a consistent band rather than trending in one direction.
After adding refrigerant, the new charge must distribute through the entire system. Liquid refrigerant added at the service valve needs time to flow through the metering device, evaporator, and back to the compressor. Allow a full 15-20 minutes after the last charge addition before evaluating superheat or subcooling.
Common mistake: Adding charge, checking superheat two minutes later, seeing it is still high, and adding more charge. This leads to overcharging. Wait for stabilization before evaluating.
Changing the thermostat setpoint can cause the system to cycle or change operating modes. If the system was running in a lower stage and ramps to a higher stage, or if the system cycles off and back on, the stabilization clock resets. Wait 10-15 minutes from the last mode change.
Heat pumps in heating mode periodically enter defrost. During defrost, the system reverses to cooling mode briefly, pressures and temperatures swing dramatically, and all diagnostic readings become meaningless. After defrost completes, wait at least 5 minutes for the system to return to steady-state heating operation before evaluating or saving.
Tip: If you suspect a defrost cycle is about to occur or just occurred, watch for a sudden pressure reversal (suction and discharge pressures swapping relative positions). The system will return to normal after defrost completes.
Opening doors or windows during a cooling test changes the building's thermal load. Return air temperature shifts, which affects supply air delta-T and, on piston systems, the target superheat calculation (via return air wet bulb). Keep the building envelope closed during testing. If a door was opened, allow 5-10 minutes for indoor conditions to restabilize.
Follow this sequence for every test.
Start the system (or confirm it is already running). Deploy all probes per your workflow (see Outdoor Probe Placement for outdoor probe positions). Ensure probes are connected and transmitting live data to measureQuick.
Set a timer for 15 minutes from the point the system starts running in its current mode. This is your minimum wait time. Use this time productively: complete visual inspections, take equipment photos, document the system profile, or walk the indoor checklist.
Tip: The 15-minute wait is not wasted time. It is part of the diagnostic process. Use it for all the tasks that do not depend on stabilized readings.
Watch the stability indicator and the measurement trends. You are looking for the transition from "Stabilizing" to "Stable." If you have the detail views open, watch for the trend lines to flatten.
Even after the stability indicator confirms ready, do a quick manual check:
If any measurement is still drifting, wait longer. Reset your patience. The goal is accuracy, not speed.
Once all stability checks pass, save the Test In or Test Out. The data now reflects actual system performance at steady state.
Saving during transient operation has real consequences:
After repairs, the same rule applies. This is the most common mistake with Test Out: the technician completes a repair, restarts the system, and saves Test Out within a few minutes. The system has not re-stabilized after the work. The Test Out data does not reflect the true post-repair condition. Always wait for stability after any service work before saving Test Out.
If you realize you saved too early, you have options. You can run the test again after the system stabilizes and save a new result. The earlier data remains in the record but the updated test reflects the true operating condition.
If the system has been running for 20+ minutes before you begin testing, it may already be at or near steady state. Deploy your probes and monitor for 5-10 minutes to confirm. You may not need the full 15-minute wait, but verify with the stability indicator before saving.
If you add or remove refrigerant during a service visit, the stabilization clock resets. You must wait another 15-20 minutes after the last charge adjustment for the system to redistribute and re-stabilize before saving Test Out. Do not evaluate the charge result during the redistribution period.
Variable-speed systems modulate continuously to match load. Their readings may have more variation than single-stage equipment even at "steady state." The key is that the variation stays within a consistent band. If superheat bounces between 11F and 15F for 10 minutes (same range), that is the system's steady-state operating window. If it is trending consistently in one direction, it is still transitioning.
Variable-speed systems also ramp through multiple speeds after startup. You may see pressures and temperatures shift as the compressor changes speed. Wait until the system settles at its target operating speed before evaluating. On some equipment, this can take 20-30 minutes. See the "How to Use measureQuick with Variable Speed Equipment" video referenced below for a walkthrough of variable-speed stabilization.
Combustion measurements (CO, CO2, O2, stack temperature, draft) also require stabilization, though they typically settle faster than refrigerant-side measurements. Allow 5-10 minutes of sustained burner operation before evaluating combustion diagnostics. Stack temperature is the slowest combustion measurement to stabilize; draft and gas concentrations settle within 3-5 minutes.
The Gas Furnace Workflow video demonstrates this process: "I'm going to go ahead and put this in the stack and once that stabilizes for a second here I'm going to go ahead and capture my draft reading... so I'm going to let that run for a few minutes and watch this closely." Similarly, the BluFlame analyzer review shows watching "the O2 level come up and stabilize" before evaluating the combustion readings.
Aaron Gregg (Service Manager, Jacob's Ladder Heating and Cooling): "Customers have told me multiple times, I've never had a company show me that type of thing before." The accuracy that comes from waiting for stabilization is what makes the customer report credible. Rushing the save produces false failures that undermine the report's value.
Michael Housh (Owner, Housh Home Energy): His previous "monstrous spreadsheet checklist" was "cumbersome and easy to pencil whip." By contrast, measureQuick's stabilization discipline and instrument-verified readings cannot be fabricated. The wait for stable readings is part of what differentiates measurement-based service from opinion-based service.
Chad Simpson (Owner, Simpson Salute): "We went from 4% callback range down to under 2%." Part of that callback reduction comes from ensuring accurate diagnostics through proper stabilization before saving, which prevents false failures that trigger unnecessary return visits.
YouTube: (6:40). Jim Bergmann demonstrates stabilization in practice: "I always recommend you just go ahead as soon as you start the system up, capture the air handler data. You want to wait a few minutes for the system to stabilize, and that's what I have the condensing unit actually streaming in live, so I want to wait till the condensing unit reaches its stability before I capture the electrical data, because the more work we're doing as the system runs, the more work we're doing, the condensing unit will creep up on there." This captures the core principle: different measurements stabilize at different rates
YouTube: (17,774 views, 17 min). Covers stability detection improvements introduced in version 3.0, including updated algorithms for better handling of variable-speed equipment and gradual drift
YouTube: (80 min). Includes practical stabilization guidance: "all you have to do is deploy your probes and wait for the system to stabilize." Use the wait time to complete other workflow tasks
YouTube: (13 min). Demonstrates productive use of stabilization time: while waiting for the system to stabilize in heating mode, connect the electrical meter to Bluetooth and complete other workflow checklist items
YouTube: (9,324 views, 18:40). Demonstrates stabilization behavior on variable-speed systems, including how long to wait and what readings look like during the ramp-up phase
YouTube: (66,533 views, 72 min). Jim notes that a typical system "takes about seven to eight minutes to actually get stabilized," though conditions vary
YouTube: . Demonstrates combustion-side stabilization: watching the O2 level come up and stabilize before evaluating readings
The stability algorithm uses a rolling window. If the drift is very gradual (0.5F per minute), it may fall within the algorithm's tolerance. Do the manual check: note superheat, wait 2 minutes, check again. If it moved more than 2F, wait longer.
This can happen if the system cycles between stages (multi-stage or variable-speed), if defrost initiates, or if indoor conditions changed (someone opened a door, oven turned on, dryer started). Identify what changed. If the system mode changed, wait for it to re-stabilize in the new mode.
If the system has been running for 30+ minutes and readings are still unstable, the instability is likely a system problem, not a stabilization issue. Possible causes: intermittent TXV, restriction, low charge causing compressor cycling, electrical issue, or airflow problem. Document what you see. The instability is diagnostic information.
Only if the system genuinely had not reached steady state. If you saved Test In early and the charge failed, the better approach is to re-run the test after stabilization rather than overriding the result. An override removes the failure from the record; a re-run replaces it with accurate data.
Variable-speed systems modulate continuously to match load. Their readings may have more variation than single-stage equipment even at "steady state." The key is that the variation stays within a consistent band. If superheat bounces between 11F and 15F for 10 minutes (same range), that is the system's steady-state operating window. If it is trending consistently in one direction, it is still transitioning.
If a probe loses connection and reconnects, the app may need a few minutes to re-establish a clean data stream. Verify that the reading looks reasonable and that the stability indicator reflects the reconnected state before saving.
Changing an adjustable parameter (target superheat, subcooling range, design airflow) changes the diagnostic thresholds, not the actual readings. But if you also made a physical change to the system (adjusted blower speed, changed charge), the readings themselves will shift and need time to re-stabilize. Wait for the new steady state before saving.
